Fulscot Bridge update

Latest update from Network Rail regarding the bridge works:

We continue to make good progress at Fulscot Road. The current status of the works is as follows:

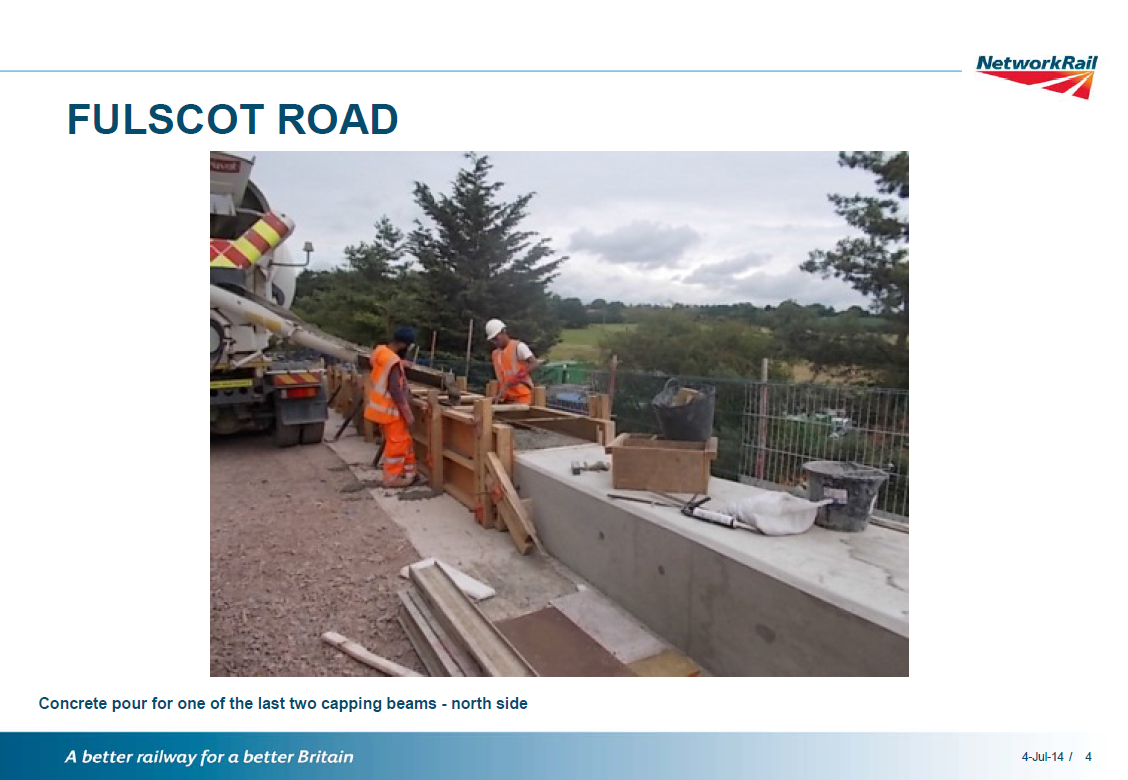

  • North Capping beam to sheet piles
completed 04/07

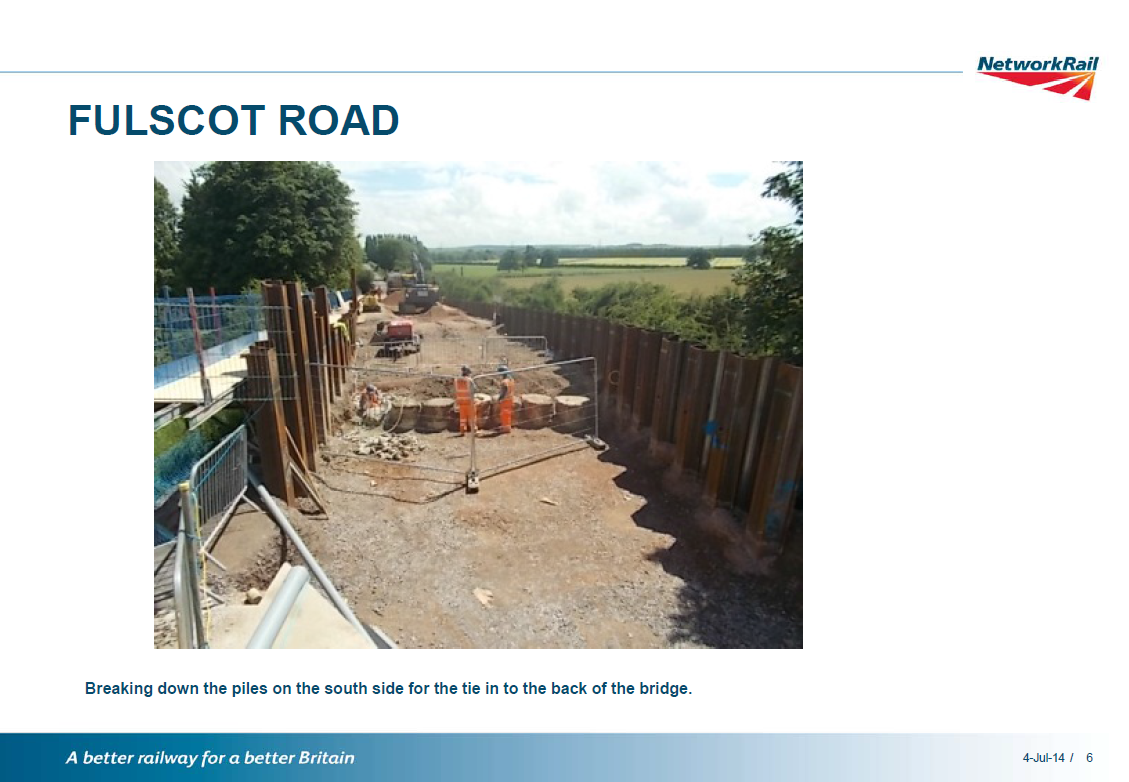

  • South capping beam to sheet piles – ongoing
complete by 01/08

  • Soil nail netting (to enable road opening)
completed 04/07
  • Capping beam for augured piles
will complete 07/07

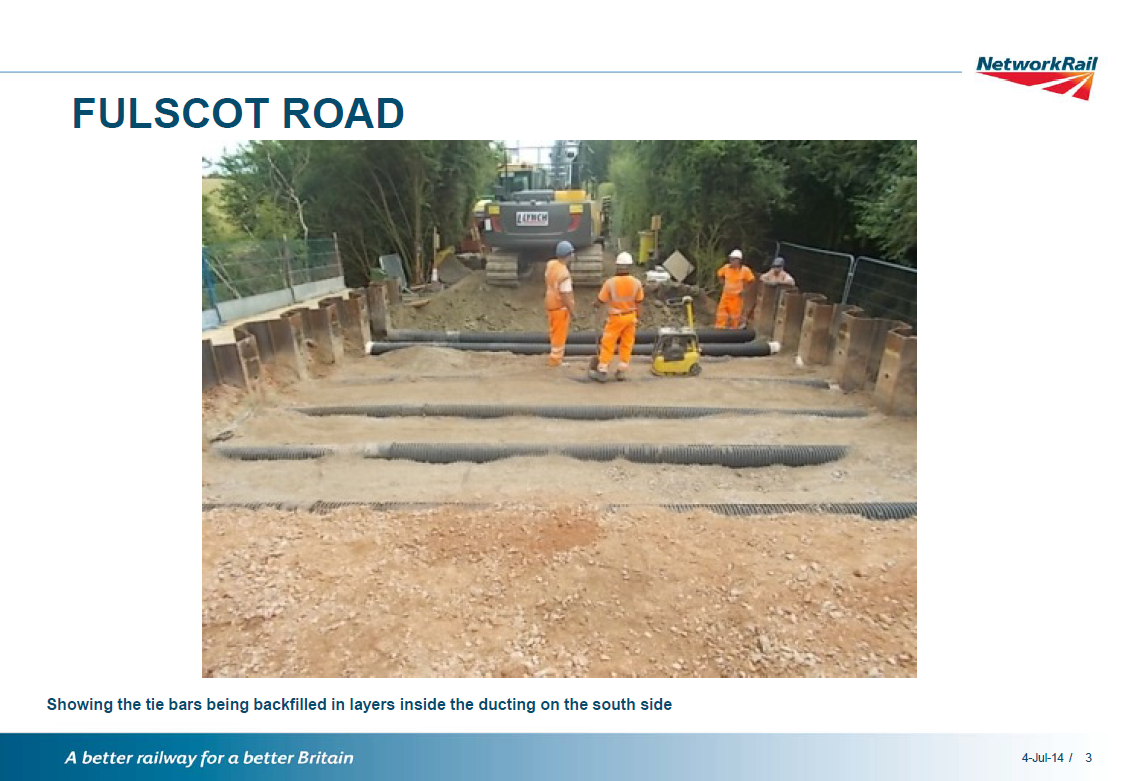

  • Ties (abutment/augured piling cap) back fill
 complete by 10/07
  • L-units (delivery 01/07 onwards)
 complete by 08/07
  • Road works (sub-base/kerbs/drainage)
  complete by 15/08
  • Surfacing
 complete by 22/08
  • Barrier installation
 complete by 29/08
  • Road Open
 2/9/14

We are still on target for opening the road by early September 2014.
